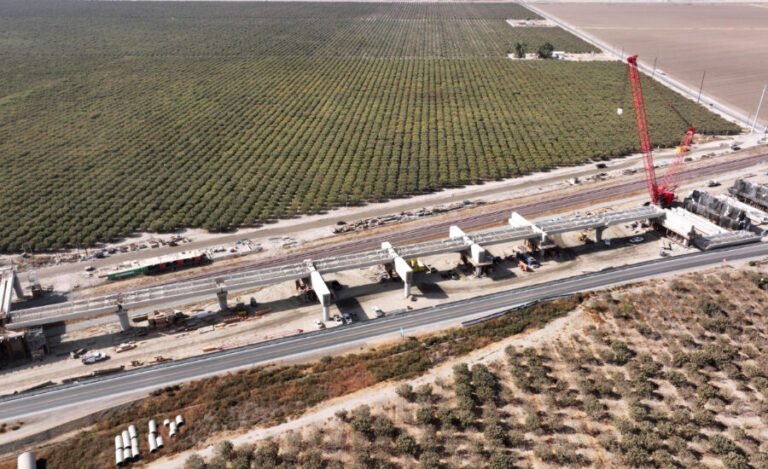

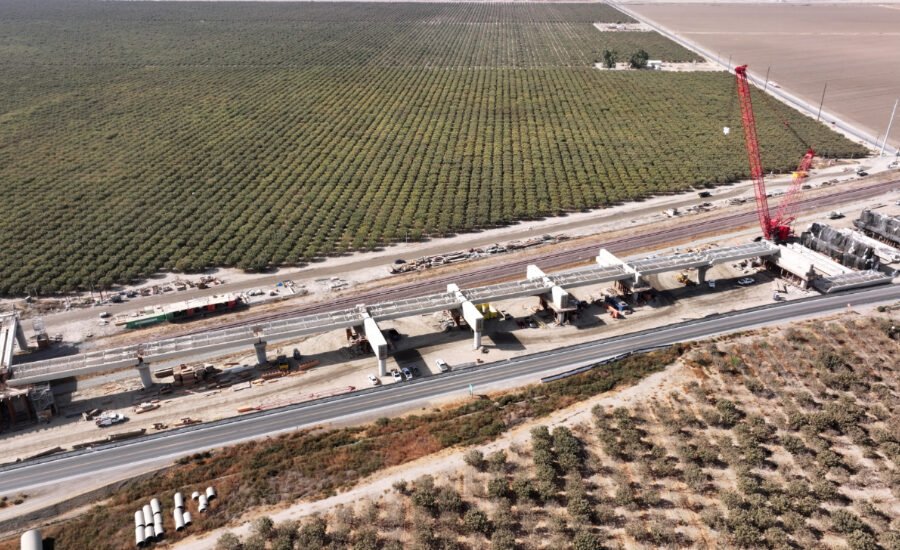

The Federal United States Transport Transport Federal Administration does not believe that the California High Speed Rail Authority will be able to deliver a 171 -mile segment of the system provided for its 2033 deadline, federal officials wrote in a report that Dot published on June 4. FRA officials proposed to finish a couple of $ 4 billion grants, as CHSRA was already facing a $ 6.5 million fund service for work.
FRA officials cited the large number and value of change orders in project construction contracts, a lost shot bag hiring period, the scarcity of funding and other problems in their report, concluding that CHSRA will probably not be able to complete the early operating segment in time for 2033, as established in a grant agreement or to complete the high rail system.
“This report exposes a cold and hard truth: CHSRA has no viable way to complete this project in time or budget,” said Secretary of Transport, Sean Duffy, in a statement.
CHSRA plans to build a high -speed railway system of 800 miles in two phases. The first phase would be about 500 kilometers by connecting San Francisco with Los Angeles and Anaheim, and the second phase would extend the line to the north to Sacramento and to the south to San Diego. The construction is currently underway 119 kilometers from an early operation segment of 171 miles that Chsra intends to go into service in 2033.
The cost estimate for the first phase is $ 106.1 billion, an increase of 31% compared to the cost estimate of 2020 and an increase of 222% over the estimation of original costs of $ 33 million from when California voters approved a voting initiative for the project. About $ 6.9 billion in funding comes from federal sources. The grants FRA has proposed to end include a $ 949 million prize run in 2011 and a $ 3 million prize run last fall.
The authority “does not agree strongly with the conclusions of the FRA, which are wrong and do not reflect the substantial progress carried out” in the project, a spokesman for Chsra said in a statement.
“We are firmly committed to complete the first real high -speed rail system in the country that connects the main population centers in the state,” they said.
Most of the project’s funding comes from the state and the governor’s budget proposal Gavin Newsom before the state legislature extended at least billion dollars in funding per year for the next 20 years, the spokesman said. This would provide the resources needed to complete the initial operating segment, they added.
Time and Orders of Change
There are two problems raised in the report that seriously threatens the state of the subsidies. First, FRA officials wrote that CHSRA did not end the hiring of shooting bags until last December. The agency modified its hiring three times in the last year, promoting the completion of the process in July and constituted “persistent breach” according to the terms of the subsidy agreement, wrote the FRA officials.
The project has also seen “numerous” change orders, according to FRA, which has helped increase costs. CHSRA approved more than 1,000 change orders in March 2023, including 20 by a total of more than $ 500 million related to the construction of barriers intended to prevent any possible derailment of freight trains from affecting the high-speed line.
Since the beginning of 2023, the exchange orders have added a combined value of $ 1.6 billion, according to the report, “suggests that a substantial part of all payments to contractors are being taken out of the original terms of negotiated contracts.” In addition, FRA officials wrote that Chsra is in a contractual dispute with Dragados/FlatIRON Joint Venture, the main contractor in one of the three built packages of the central valley so far. Change orders increased the price of the contract by 62% compared to the initial offer of $ 1.2 billion for work in the 65 -mile segment, and FRA officials said that the contract dispute could delay the completion of this package in at least eight months until August 2027.
If the 171 -mile early operation segment is not complete by 2033, this could be a “material change” that could justify the completion of the subsidies, according to the FRA officials.
“The large volume and frequency of these exchange orders shows waste through an inexcusable combination of poor planning, implementation or mismanagement of contractors, legal authority and insufficient technical expertise and other factors,” they wrote.
FRA gave Chsra seven days to provide an initial response and another 30 to provide a corrective action plan if he wants to answer the end of the grant.
“Our country deserves a high -speed railway that makes us proud: not Boondoogle trains to anywhere,” said Duffy.
In his statement, Chsra’s spokesman said that the authority “will fully address and correct the registration in our formal response to FRA notice.”
