WIs the chicken a complete project?
Being clear about the completion has always been important to pay, but now it can make the difference between getting insurance coverage or the refusal.
This was raised in December by a Judge of the Federal Resource Court in Atlanta Hearing Arguments in a case called Liberty Surplus Insurance Corp. Against Kaufman Lynn Construction, Inc. The question is worried that the general associated contractors are planning a meeting on the subject in September.
Different interpretations of the Civil Liability Insurance Program controlled by contractors (CCIP) bought by Kaufman Lynn Construction emphasizes the judicial case.

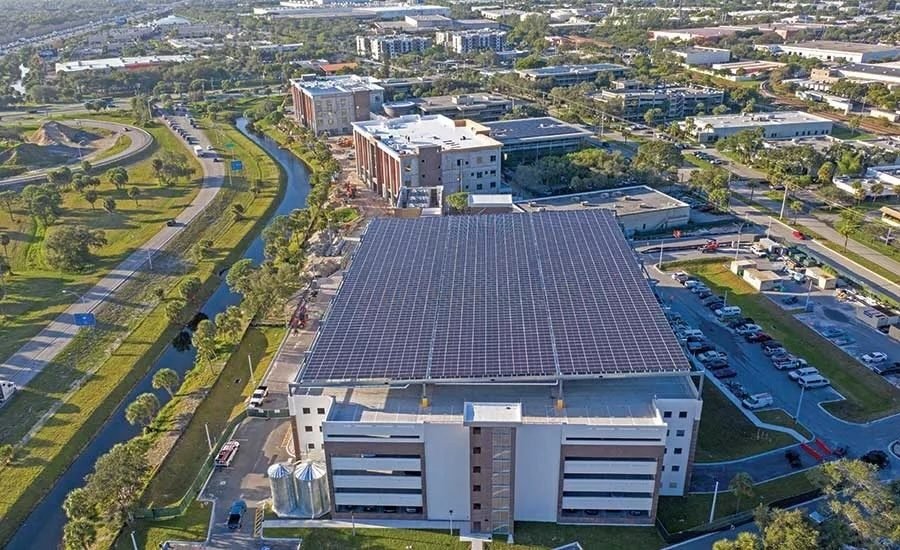

In 2018, JM Family Enterprises of Deerfield Beach, FLA. The campus included office buildings, dining room, energy plant and a garage. To protect himself and his subcontractors, Kaufman Lynn obtained a Commercial General Responsibility Policy (CGL) through Liberty excludes Intcus Icencence Corp., structured as CCIP.
These policies have become popular as a profitable way to secure all companies that work on complex projects.
In November 2020, Kaufman received employment certificates for office buildings, dining room, energy and garage plant. The Tropical ETA storm then reached southern Florida and caused $ 3.3 million in water damage to the completed portions of the campus. Kaufman Lynn presented the coverage of Liberty’s surplus, but the insurer denied the claim, pointing to the policy construction exclusion course (CECE), which delayes the coverage until the entire project is completed.
The different definitions of “project” and “complete” became a problem.
The parties sought a legal remedy. In February 2023, a Federal Judge of West Palm Beach, Donald M. Middlebrooks, ruled that CECE’s coverage prevented the project from being completely completed despite the fact that some buildings have employment certificates. The judge agreed with Liberty’s definition of “project” and “completed” and rejected Kaufman Lynn’s effort to apply a definition of the policy operations danger section, which he considers to be “completed” when used.
Kaufman Lynn had also requested reform, which in legal cases requires that the parties return to the original contract to “reform” an error or misunderstanding in the language.
The judge diffused the reform argument and gave Kaufman Lynn until March 17, 2023, to present a brief. But the other parts of the decision were and Kaufman Lynn resorted. A group of federal judges heard oral arguments in December. Lawyers continued to discuss the meaning of the project and the completion.
AGC and the housing builders enter
Industry associations were involved at this time. AGC, with the support of the Florida chapters and the National Association of Housing Builders, presented a friend of demand for demand for Kaufman Lynn.
The author of the brief, Patrick J. Wielinski, director of the Dallas Cokinos law firm, argued that exclusion should not be applied to occupied and substantially complete phases. Wielinski described the insurer’s actions as a “bait and switching” scheme, where marketed coverage does not protect against real risks due to the language of ambiguous policies.
In the brief, Wielinski also argued that the exclusion of a CGL policy should not be applied to the work that has achieved a certificate of employment, where the exclusive possession has passed to the owner and the danger coverage of the policy operations is triggered.
Liberty excludus lawyer Carol Rooney, a member of Hinshaw & Culbertson Llp, answered the questions of the Judges of the Court of Appeal on Liberty’s definition of “project” and “completion”.
Rooney argued that Liberty’s position is that the “project” refers to the entire JM Family Enterprises headquarters, as described in the description of the policy project and the CCIP’s personalized guarantee, including “Buildings A, B, D and all the associated structures.” He said that politics was adapted to this specific development, and Kaufman Lynn, through his agent, agreed on this definition.
In March, the Appeal Court confirmed the interpretation of a single Liberty project, according to Liberty’s position that Kaufman Lynn should have clarified the coverage of construction by phase.
The court left the door open for the reform of the original policy and confirmed the denial of Liberty’s motion for the lawyer’s fees, citing the failure of the proposal for liquidation to resolve all claims.
In a recent interview, Wielinski states that “the reform would seem appropriate in the case of ambiguous policy language used by insurers in a manuscript envelope policy”, that is, personalized terms outside the standard contract forms, “such as the description of the project with Kaufman.”
Wielinski also warns of a “imploding disaster” if this problem is not addressed.
Other related cases of exclusion
The Kaufman Lynn case is not an isolated instance. Currently, there are other demands that involve these exclusions in court, including another in Florida,
“The hope of my clients,” says Wielinski, “in particular industry organizations such as AGC, they will be aware of the contractors of the matter and will be diligent to be clear about the definitions of” project “and” completion “in their insurance policies.”
Wielinski says: “We hope that the consciousness of the insured contractors in the subscription phase will foster a clearer language to avoid this problem. The insurance must carry out these issues.”
In addition to carefully reading policies, how should the “project and completion” debate be avoided?
“Contractors must try to negotiate withdrawal or limitation of excessively widely exclusions of risk in CCIP policies during the subscription phase,” says Wielinski. “An experienced runner can help –
